Open-cut method

Open-Cut Sewer Line Replacement

Open-cut sewer line replacement in Alberta: when digging is justified, OHS trench rules, bedding and grade, restoration, city permits and typical costs.

An open-cut corridor shows an old segmented pipe lifted above a replacement pipe, with separate soil layers and paving slabs illustrating excavation and reinstatement.
Illustrated field guideOpen-Cut Sewer Line ReplacementAn open-cut corridor shows an old segmented pipe lifted above a replacement pipe, with separate soil layers and paving slabs illustrating excavation and reinstatement. Conceptual, not to scale.
Short answer

Open-cut sewer line replacement means excavating a trench along the lateral, removing the old pipe and laying new pipe on prepared bedding at a continuous grade. In Alberta it is the usual answer for a collapse, a sag, severe offsets or pipe too deformed to line. It disturbs the surface along the dug length, so the written scope must define excavation limits and restoration.

Key takeaways
  • Open cut is the one method that corrects grade, because the trench bottom itself is rebuilt under the new pipe.
  • Alberta's OHS Code requires wall protection for workers in trenches deeper than 1.5 m, which is why deep laterals cost more to dig.
  • Private sewer and water service lines are not marked by Click Before You Dig; a private locator has to find them.
  • Restoration is the line item most often left vague; ask which surfaces are put back and to what standard.
  • Every city on this site has its own permit or approval body; the quote should name who applies and who books inspections.

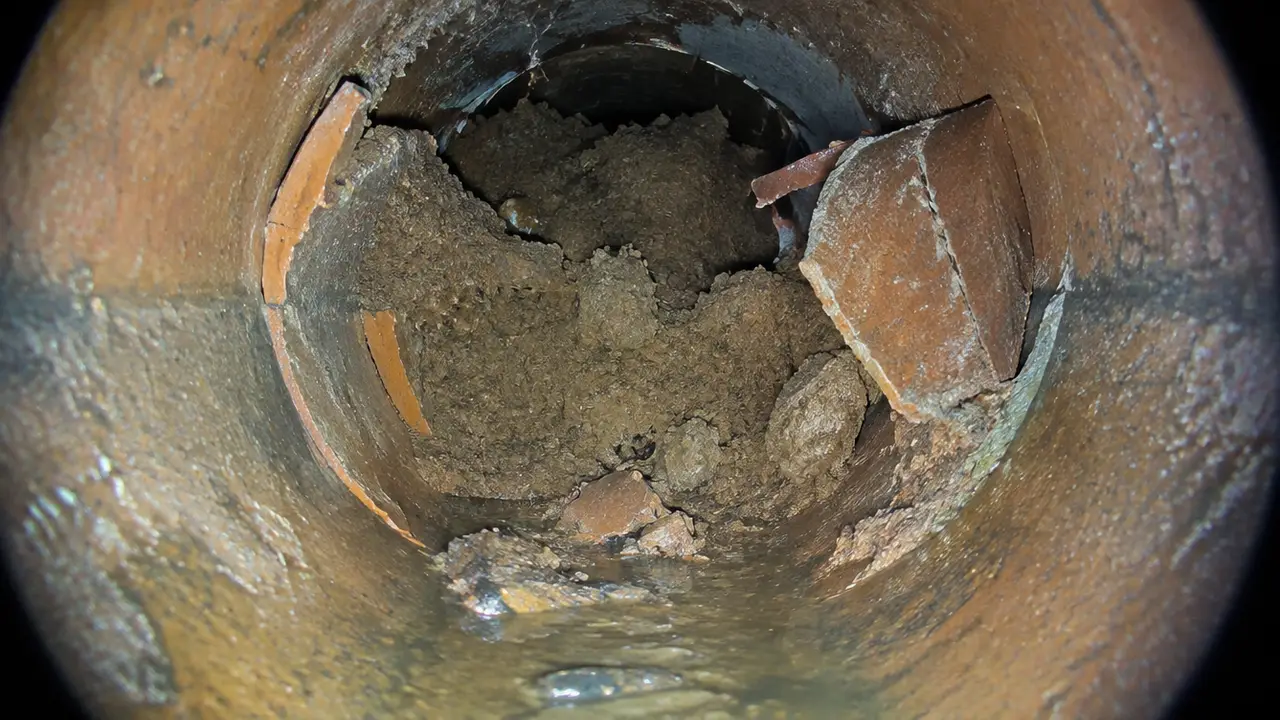

Sewer camera view of a collapsed clay pipe blocked by soil and shards
IllustrationA collapsed section: broken pipe and packed soil block the line. Cameras usually cannot pass this point.
Open-cut sewer trench in cross-sectionA trench cut across the line: spoil piled back from the edge, sloped or shored walls, a granular bedding layer under the new pipe, initial backfill around it, and native backfill compacted in lifts up to restored grade. SPOIL KEPT BACK ① BEDDING ② NEW PIPE ③ INITIAL BACKFILL ④ COMPACTED LIFTS DEPTH DEEP TRENCHES NEED SLOPING OR SHORING UNDER PROVINCIAL OHS RULES CROSS-SECTION · NOT TO SCALE
Fig. 1An open-cut trench: spoil kept back, protected walls, bedding under the pipe, backfill in compacted lifts.

01 /When is open-cut sewer line replacement the right call?

Open cut is justified when the camera shows a condition no trenchless method can correct: a collapsed or missing section, a belly that holds water, joints offset far enough to catch a camera, or pipe so deformed that a liner has nothing round to cure against. EPCOR's sewer line guidance for Edmonton (as checked September 2026) is blunt about two of these: sags can only be fixed by removing the affected pipe and regrading the trench bottom, and replacing a collapsed portion is the only viable option.

It is also the practical choice when the pipe has to change: a new route around a garage addition, a new depth to get below frost, a larger diameter, or a lateral so short and shallow that digging costs less than setting up lining equipment. It is not automatically better than trenchless work. Direct access solves some conditions; lining and bursting solve others. The methods hub shows which findings point where.

02 /What should an open-cut replacement scope cover?

A sound open-cut scope answers six questions in writing before anyone digs. They are the same six review points this page has always used, expanded with what to look for on an Alberta job.

Six things to review in an open-cut proposal
Review itemWhat it meansWhat to see in writing
Direct pipe accessThe trench exposes the run so alignment, bedding and connections can be rebuiltThe start and end points, measured from the foundation and property line
Broad condition rangeOpen cut handles collapse, deformation, poor grade and defects a liner cannot reachWhich camera findings justify digging instead of lining
Defined restoration scopeSoil, landscaping, concrete and paving disturbed by the digEach surface listed, with what is restored and what is excluded
Utility coordinationLocates, safe excavation and shoringWho requests locates, who hires the private locator, and how walls are protected
Permit reviewPermits and inspections vary by municipality and connection locationThe permit holder, the inspections, and who pays the fees
Post-work evidenceProof of the installed line, grade and connectionsA post-work camera run and any test the permit or contract requires

03 /What do Alberta's trench safety rules require?

Alberta's Occupational Health and Safety Code, Part 32, sets the trench rules every employer on a sewer dig must follow. As checked September 2026, four sections matter most for a residential lateral:

  • Section 447: before ground is disturbed, the employer must contact the owners of buried facilities, have them marked, and not dig until they are marked.
  • Section 450: a worker in an excavation more than 1.5 m deep, and closer to the wall than the depth of the excavation, must be protected by cutting back the walls, by a temporary protective structure such as a trench box or shoring, or both. Solid rock is the exception.
  • Section 451: cut-back walls must slope at not less than 30° from vertical in hard, compact soil and 45° in soil likely to crack or crumble, to within 1.5 m of the bottom; in soft, sandy or loose soil the slope starts from the bottom at 45°.
  • Section 453: spoil piles must sit at least 1 m back from the edge of the excavation, with a slope of not more than 45°.
An Alberta sewer trench and the OHS excavation rulesCross-section of a sewer trench about 2.6 metres deep. An excavation more than 1.5 metres deep needs protection for a worker closer to the wall than the depth. The left wall is cut back: no more than 1.5 metres of vertical wall at the bottom in hard, compact soil, sloped above that at least 30 degrees from vertical, or 45 degrees for soil likely to crack or crumble. The right wall is held by a temporary protective structure. The spoil pile starts at least 1 metre back from the edge with a slope no steeper than 45 degrees. FROST DEPTH VARIES ≥ 1 M SPOIL ≤ 45° 1.5 Mdeeper than this:protect the worker ≤ 1.5 Mvertical wall CUT BACK ≥ 30° FROM VERTICALhard, compact soil45° if likely to crack or crumble TEMPORARYPROTECTIVESTRUCTURE PIPE ON BEDDING ALBERTA OHS CODE PART 32 · S.450 · S.451 · S.453 · ILLUSTRATIVE, NOT TO SCALE NOBODY ENTERS AN UNPROTECTED TRENCH — NOT THE CREW, NOT THE OWNER
Fig. 2An Alberta sewer trench below frost depth: the 1.5 m protection threshold, cut-back slopes of 30° or 45° from vertical, and the 1 m spoil setback.

Those rules explain much of what a deep lateral costs. Sloping the walls back widens the trench at the surface and multiplies the soil moved; a trench box avoids that but has to be brought in and moved along. Utility Safety Partners' Click Before You Dig service needs at least three full working days' notice and does not mark customer-owned lines such as the sewer and water service, so a private locator is part of the job. The locates and digging safely guide covers the full process.

04 /How do bedding, backfill and grade decide how long the new line lasts?

A new pipe fails early when it is not evenly supported or not laid at a steady fall. Open cut is the only method where the contractor controls both, which is also why it is the only method that permanently fixes a sag.

  • Trench bottom. Soft spots, organic soil and rocks are removed so the pipe will not settle unevenly. A belly in the old line often traces back to a soft bottom that was never corrected.
  • Bedding. Granular material is placed and shaped under and around the pipe so it bears along its full length, not on its bells or on stones.
  • Grade. The pipe needs a continuous fall toward the main with no reverse slope, at no less than the minimum the National Plumbing Code sets for its size. A laser or level check before backfill is worth asking about.
  • Backfill and compaction. Fill goes back in layers and is compacted, keeping large stones away from the pipe. Poor compaction shows up later as a sunken lawn or cracked walkway.
  • Frost. Alberta laterals are buried deep to stay below frost. Confirm the design depth and any insulation with the permit body and contractor rather than a rule of thumb.

Installation craft in depth is the lane of SewerInstall.com. For a replacement decision, the point is simpler: ask how the bottom, bedding, grade and compaction will be checked, and whether the inspector sees the pipe before it is covered.

05 /How should restoration be scoped?

Restoration should be priced surface by surface, because it is where open-cut quotes differ most and where disputes start. A proposal that says only 'backfill and restore' leaves every decision until the hole is open.

  • Lawn and soil: rough grade only, topsoil and seed, or sod; and who deals with settlement over the following season.
  • Trees and shrubs: which are removed, which are protected, and whether roots will be cut near the trench.
  • Concrete: sidewalk panels, steps and driveway slabs are usually cut and replaced by the panel; ask whether the new pieces match.
  • Asphalt and curbs: often a separate trade, and on the public side sometimes a municipal requirement.
  • Fences, decks and sheds: removal, storage and reinstallation, or exclusion.

Red Deer's service application list, for example, names asphalt cutting and replacement, sidewalk and curb concrete, and turf repairs as items within the City's process (as checked September 2026). Other cities handle public-side restoration differently; confirm it with the permit body before comparing quotes.

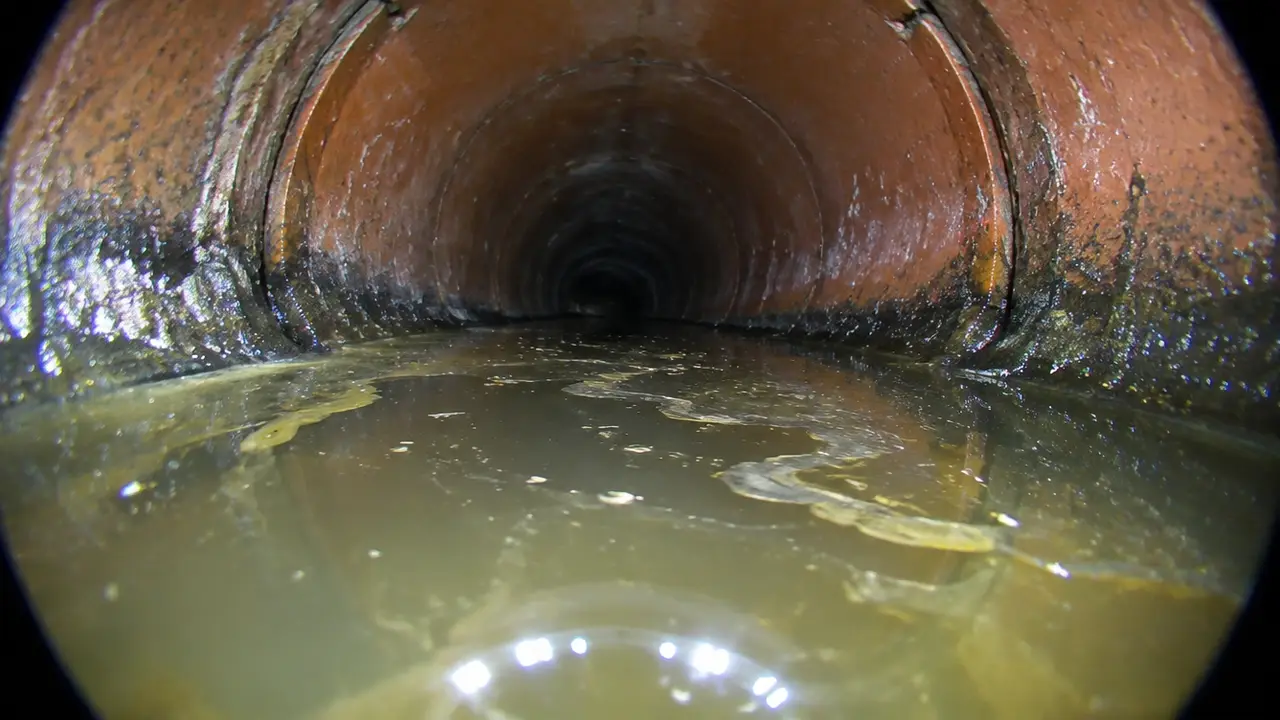

Sewer camera view of standing water in a sagging section of pipe
IllustrationA belly (sag): the line dips and holds water, and grease and solids settle in the low spot.

06 /Which permits apply to open-cut replacement in each city?

Every city on this site requires a permit or approval to replace a sewer service; what differs is the body, the applicant and the inspection. As checked September 2026:

Permit or approval paths for replacing a sewer service (confirm before work starts)
MunicipalityPermit or approvalWho applies
CalgaryPlumbing permit when sewer lines in or around the home are replaced; rough-in and final inspectionsAn owner-occupier doing the work, otherwise the contractor
EdmontonResidential plumbing permit, $120 per address or unit plus a minimum $4.80 safety code fee (other than new single-family construction)An owner-occupier of a single detached house, otherwise a City-licensed contractor
Red DeerEngineering Services approval under Utility Bylaw 3606/2018; final signature and payment in person at City HallAnyone removing or installing the service
AirdrieAccessory permit for plumbing; $100 per homeowner-led trade permit from January 2026Homeowner-led or contractor-led (hired contractors are exempt from the $100 fee); confirm with Building Inspections
OkotoksWritten approval of the CAO under Bylaw 25-21; work at the applicant's costThe applicant, in writing
LethbridgePlumbing permit to replace sewer connections; minimum fee $110.00 plus the Safety Codes Council levyA licensed plumbing contractor, or a competent resident homeowner
The permit and inspection path of a sewer replacement in AlbertaA timeline of seven stages: a written scope based on the camera record, the permit or approval, utility locates requested at least three full working days ahead, the dig with trench protection below 1.5 metres, an inspection before the pipe is covered, backfill, and a final inspection with post-work video. Below it, the body that issues the approval in six Alberta municipalities. SCOPEcamera-basedwritten scopePERMITcontractor oreligible ownerLOCATES≥ 3 fullworking daysDIGprotectionbelow 1.5 mINSPECTbefore the pipeis coveredBACKFILLbedding andcompactionFINALinspection +post video NO COVER UNTIL INSPECTED WHO ISSUES THE APPROVAL (PUBLIC PAGES, AS CHECKED SEPTEMBER 2026) CALGARYCity plumbing permitEDMONTONCity plumbing permitRED DEEREngineering Services approvalAIRDRIEAccessory (trade) permitOKOTOKSCAO written approval (connection)LETHBRIDGECity plumbing permit CONFIRM THE CURRENT REQUIREMENT FOR YOUR ADDRESS AND SCOPE BEFORE WORK STARTS SCOPE → PERMIT → LOCATES → DIG → INSPECT → BACKFILL → FINAL
Fig. 3The permit path of a replacement: scope, permit, locates, dig, inspection before cover, backfill, then the final inspection and camera run.

Alberta has used the National Plumbing Code of Canada 2020 since April 1, 2023, and the province notes that contractors may need a Restricted Certificate of Competency 'R' for sewer and water services. The City Sewer Rules Finder adds each city's ownership split and source link, and the DIY permit guide covers homeowner permits.

07 /What does a typical open-cut project look like, step by step?

  1. Review the camera record

    Confirm the failure type, location, extent and pipe material, and whether the full run was viewed.

  2. Map scope and access

    Locate the private lateral, the property boundary, public utilities, connection points, depth and surface constraints.

  3. Confirm the proposal

    Check excavation limits, pipe material and diameter, grade, bedding, permits, inspections, exclusions, restoration and written terms.

  4. Excavate and replace

    The chosen contractor exposes the agreed section, protects the walls as Part 32 requires, and installs the specified pipe and connections.

  5. Test and document

    The inspector sees the work before cover where the permit requires it, and a camera run records the new line.

  6. Restore agreed surfaces

    Backfill, compaction and restoration follow the written scope, not assumptions made before the dig.

08 /What does open-cut sewer replacement cost in Alberta?

For a 15 to 25 m residential run, open-cut replacement is typically quoted at $12,000–$35,000+. Soft landscaping under about 2 m deep runs around $12,000–$25,000 ($600–$1,000 per metre); deep trenches of 2.5–4 m or runs under hard surfaces reach $22,000–$50,000+ ($1,000–$2,000 per metre).

  • Mobilisation and utility locates: $500–$2,000.
  • Permits and inspections: $150–$1,000+.
  • Municipal connection or tie-in: $0 to $15,000+, depending on who owns the public side and what the city requires.
  • Backfill, compaction and restoration: $500–$15,000+.
  • Post-work camera video: $0–$400.
  • Adding a backwater valve while the line is open: $1,800–$4,500.

The pricing page shows how the line items stack, and why Alberta costs more explains depth, frost and trench rules. With the line open, it is also the cheapest moment to add a backwater valve.

09 /What should you ask an open-cut contractor?

  • Show me the camera evidence and the measured defect locations.
  • Why is a spot repair or trenchless option unsuitable for this line?
  • Which permits, locates, excavation limits and restoration items are included?
  • What pipe material, diameter, grade, bedding and connections will you install?
  • How will you protect the trench walls if it is deeper than 1.5 m?
  • Do you hold a prepaid contracting licence if you take a deposit? (Service Alberta's Find a Licensed Business search confirms it.)
  • What testing, inspection, warranty and exclusions will be in writing?

Bring the answers and the camera record to the request form for a scope review, or run the Replacement Readiness Check first.

FAQQuestions people ask

When do Alberta contractors recommend open-cut sewer replacement over a liner?

Usually when the camera shows a collapse, a belly holding water, badly offset joints or deformed pipe. EPCOR states that a sag can only be fixed by removing the pipe and regrading, which only excavation does. The contractor should tie the recommendation to measured findings.

Does open-cut replacement in Alberta mean digging up the whole yard?

Not always. The trench follows the affected run, and its width depends on depth and soil because walls over 1.5 m need cutting back or shoring. Ask for the excavation limits and the restoration of each surface in writing.

Is open-cut replacement better than trenchless for older Calgary and Edmonton laterals?

Neither is better in general. Open cut gives direct access and fixes grade; lining keeps the surface intact when the host pipe is sound; bursting replaces broken pipe along the old route. The camera record should justify the choice.

Who books the sewer inspections on an open-cut job in Alberta cities?

The permit holder. In Calgary and Edmonton that is the owner-occupier doing the work or, far more often, the contractor. The written proposal should name the permit holder, the inspections, the fees and who pays each.

What warranty should an Alberta open-cut sewer replacement come with?

Terms vary by contractor, pipe material and scope. Ask for the labour warranty and the manufacturer terms in writing, including exclusions, transfer to a buyer and the claim process, before you sign or pay a deposit.

Can open-cut sewer work in Alberta go ahead in winter?

It can, but frozen ground, frost protection and restoration timing change the price and schedule. Landscaping restoration is often deferred to spring. Confirm how the contractor handles frozen spoil, heating and deferred restoration in the written scope.
